Scope of Work & Bid Worksheet
Attached Garage Rebuild
Rebuild of an attached garage destroyed by a fallen tree. The scope below is drawn from the insurance adjuster’s estimate — garage-related lines only — priced at replacement cost (labor, materials, tax and 10%+10% overhead & profit included).
Before & After

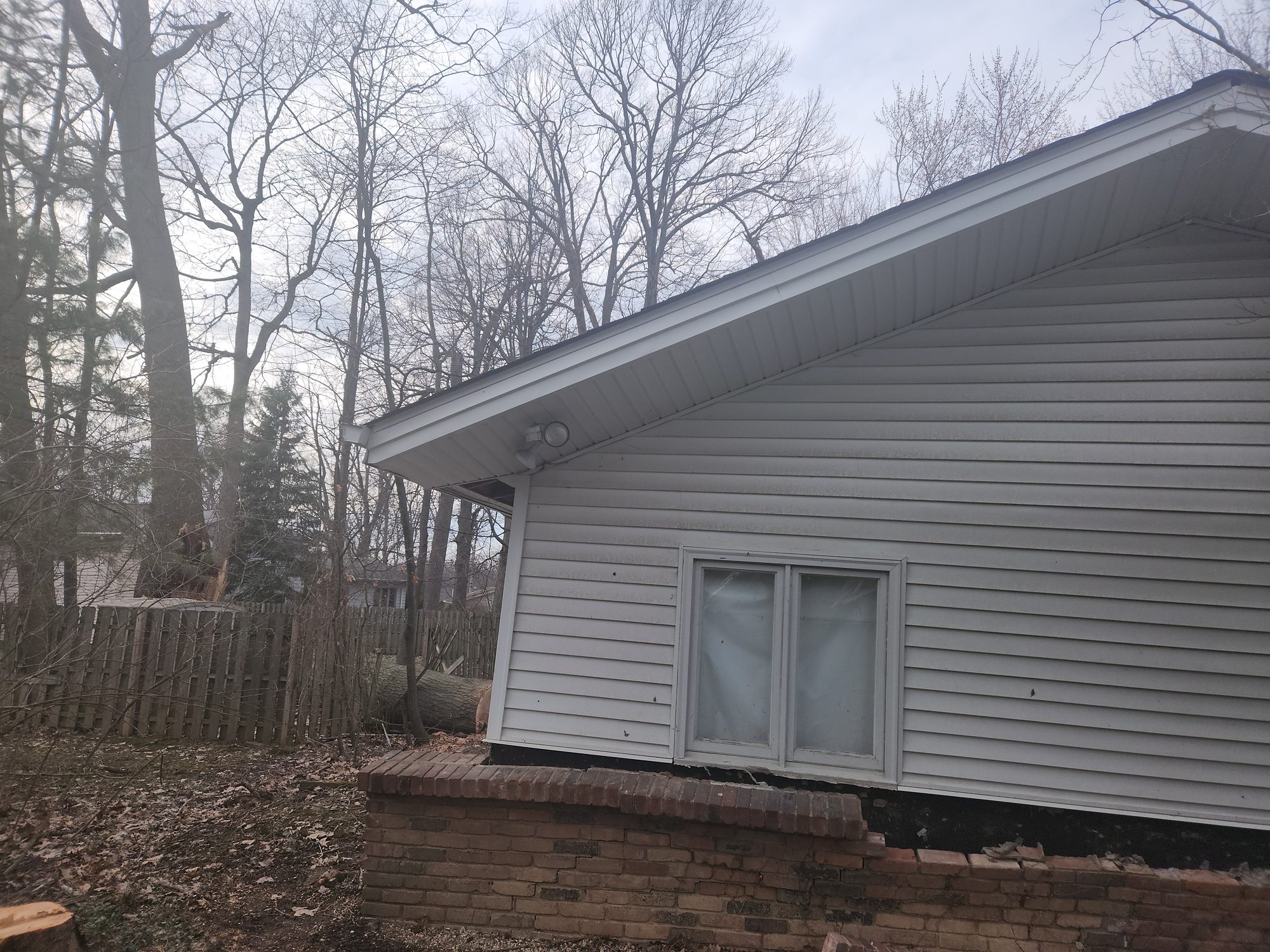

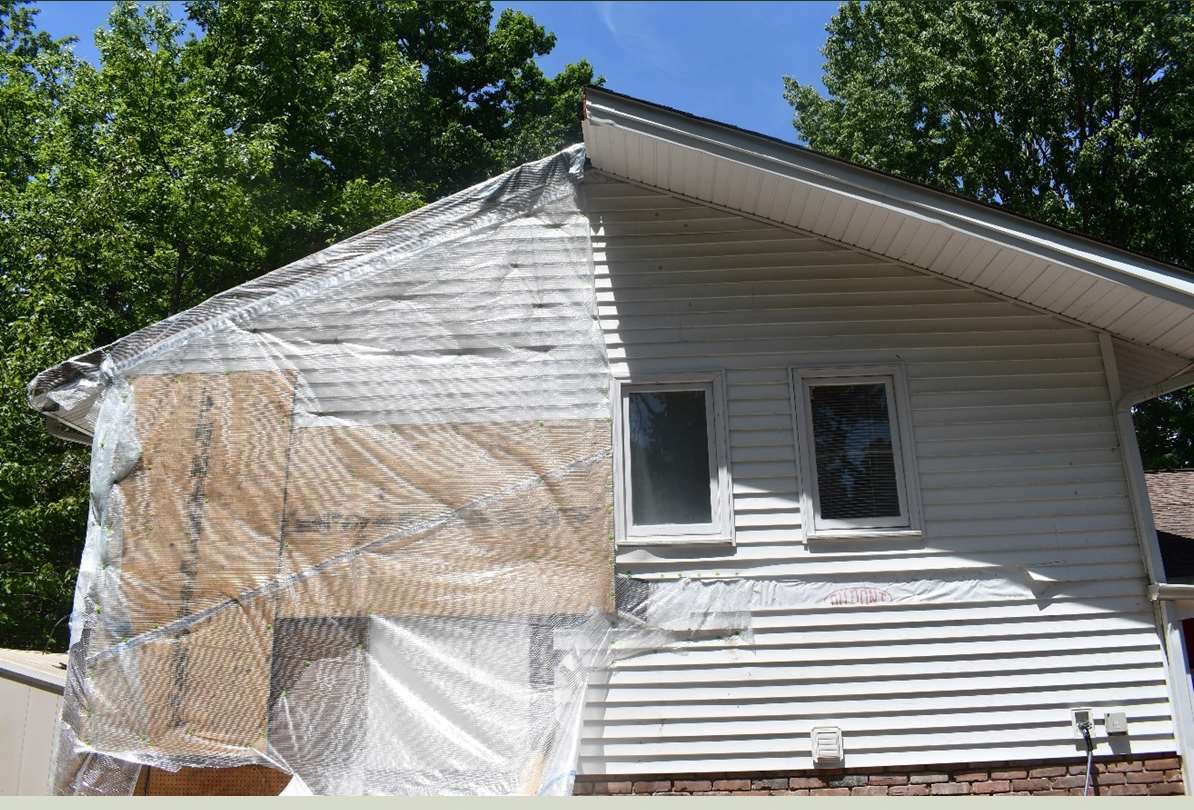

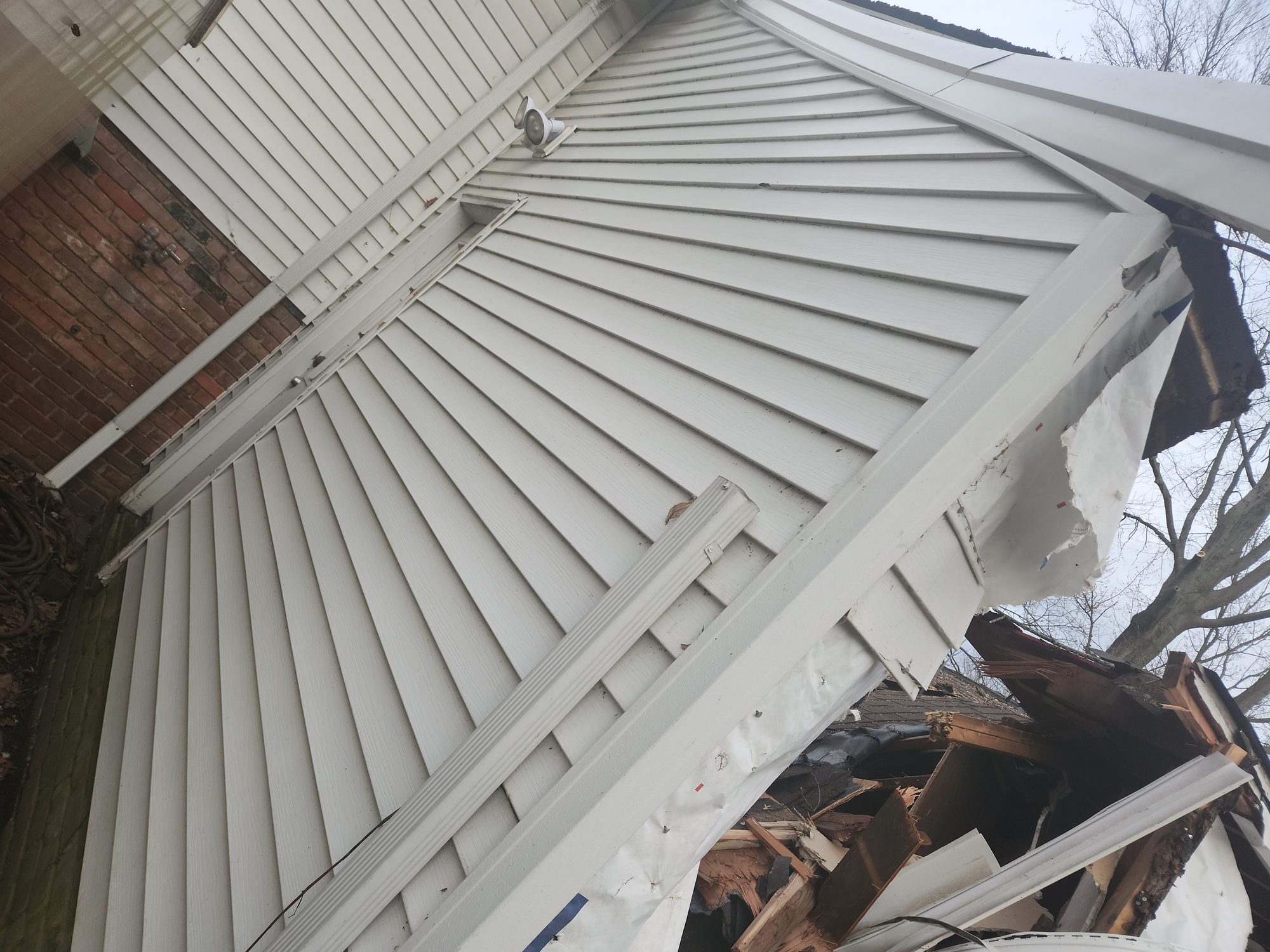

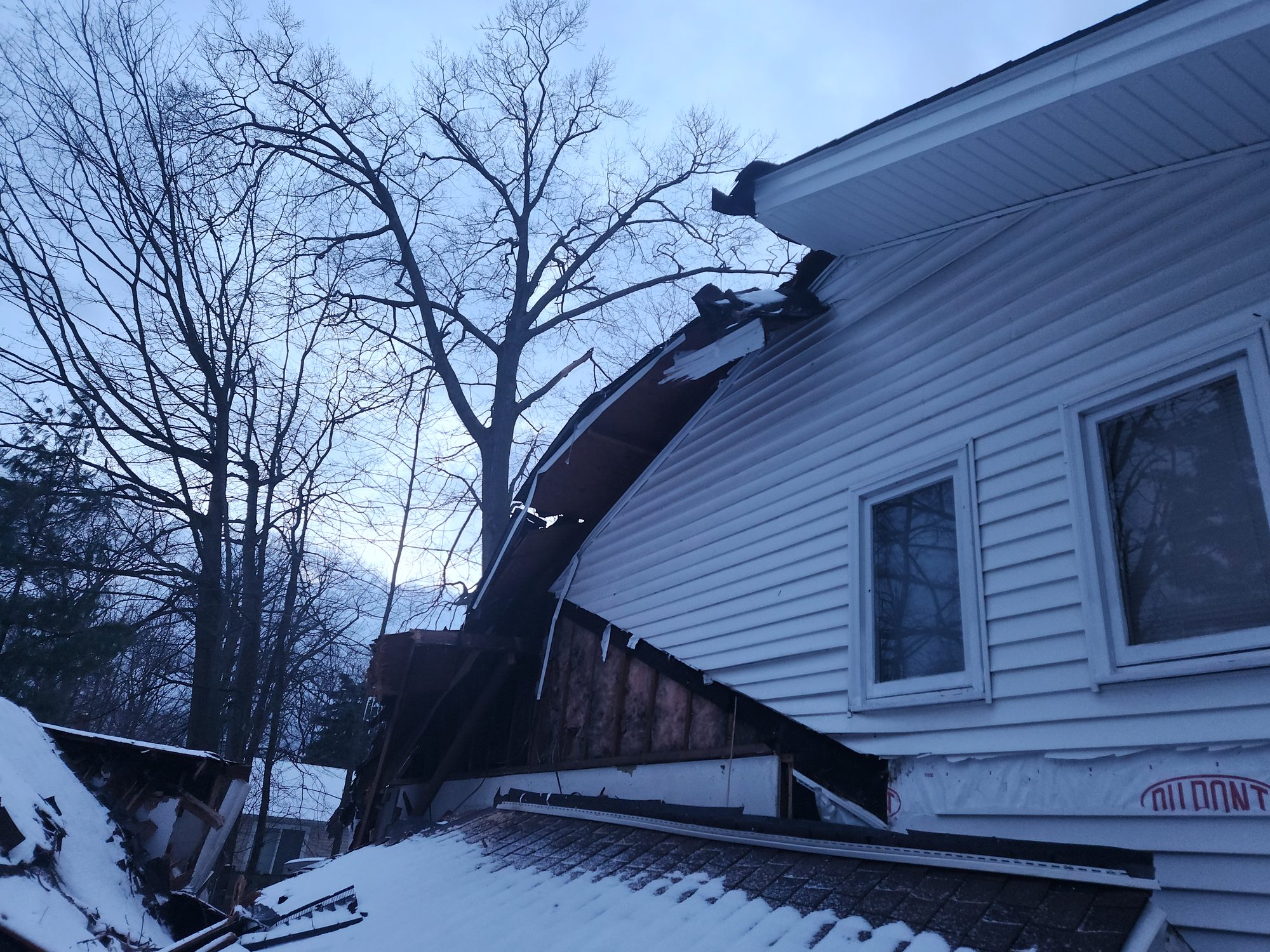

Before — the garage as it stood

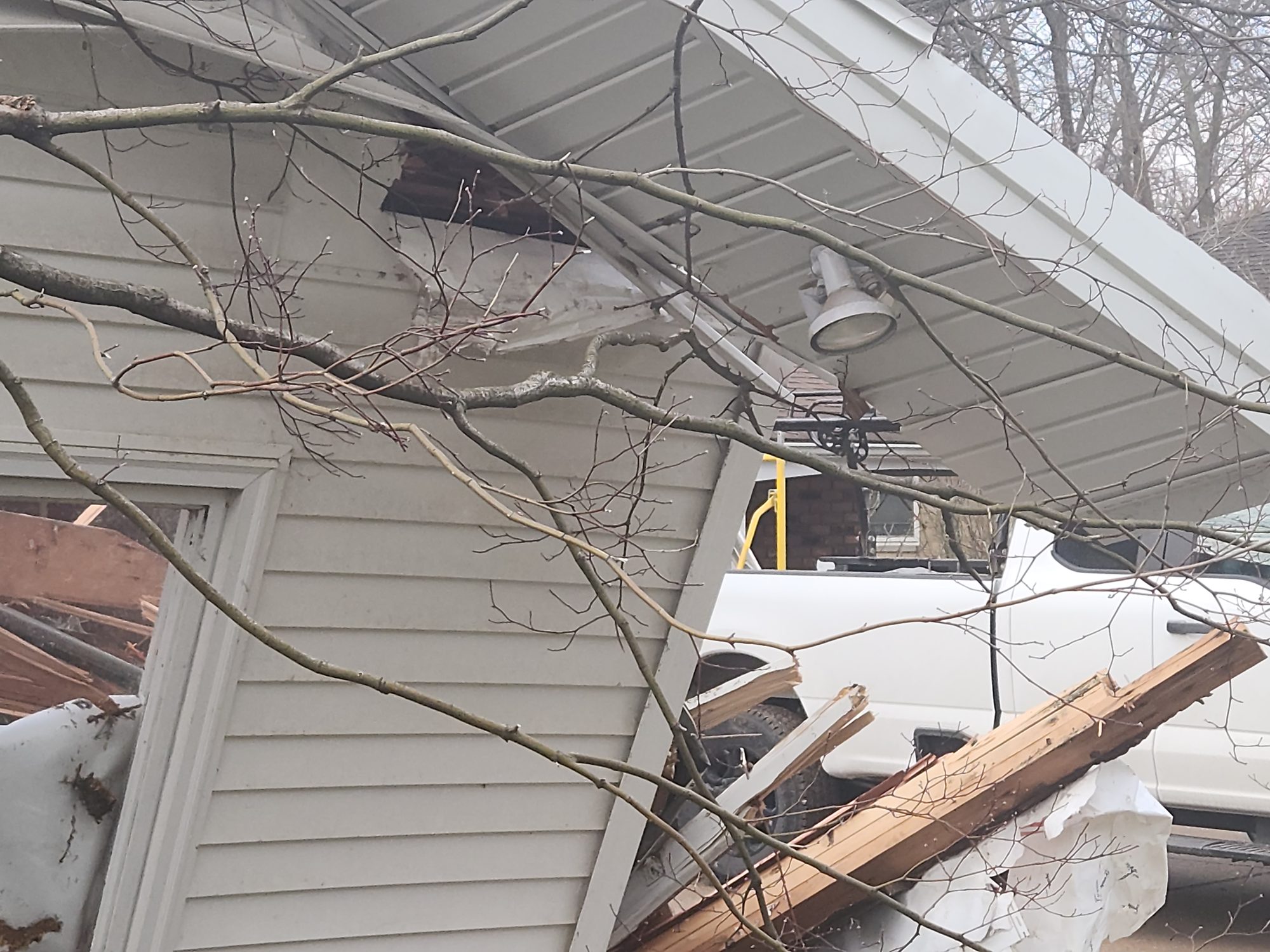

AI enhanced

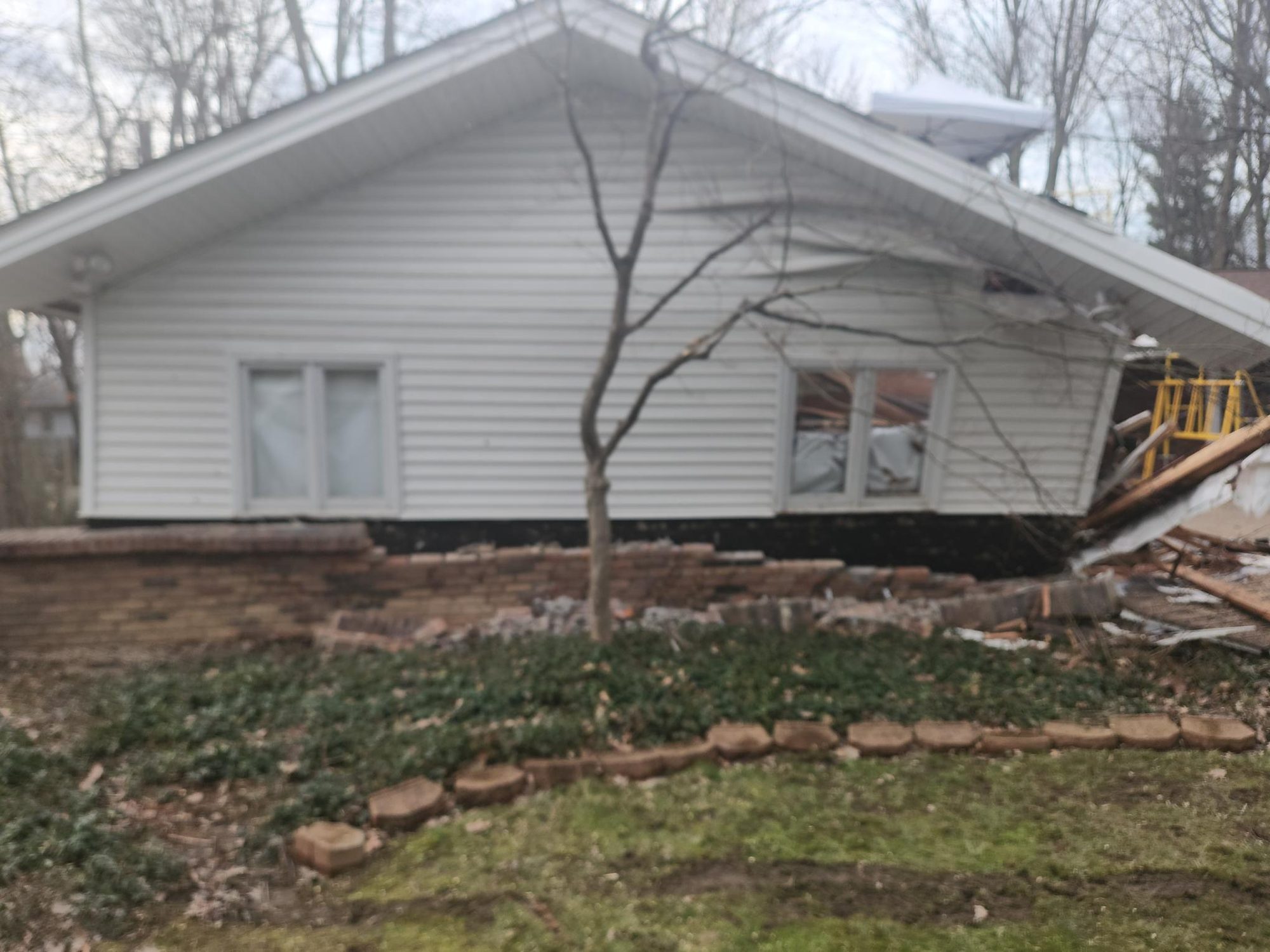

AI enhanced
AI enhanced

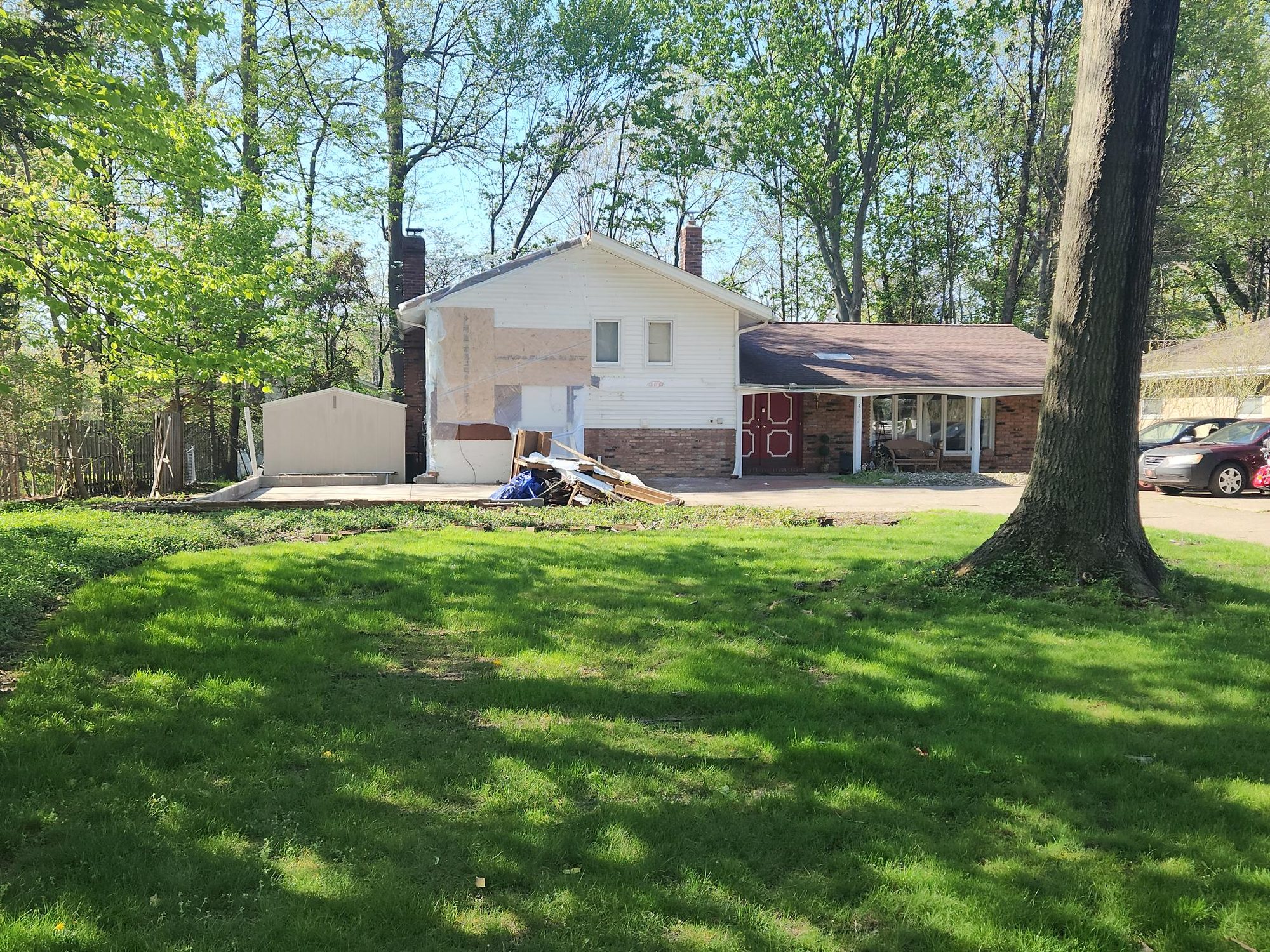

After — the site today, and how it got here

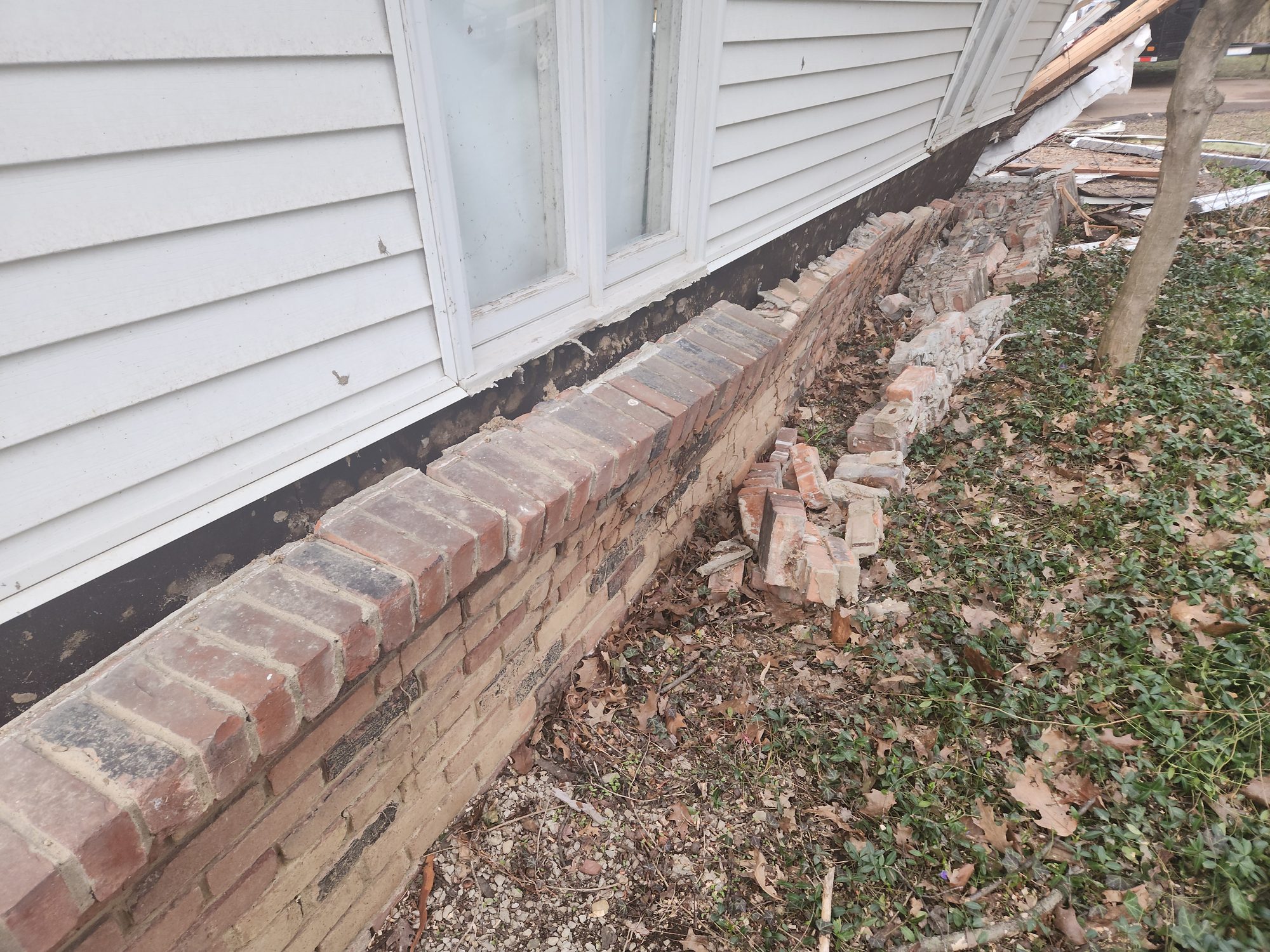

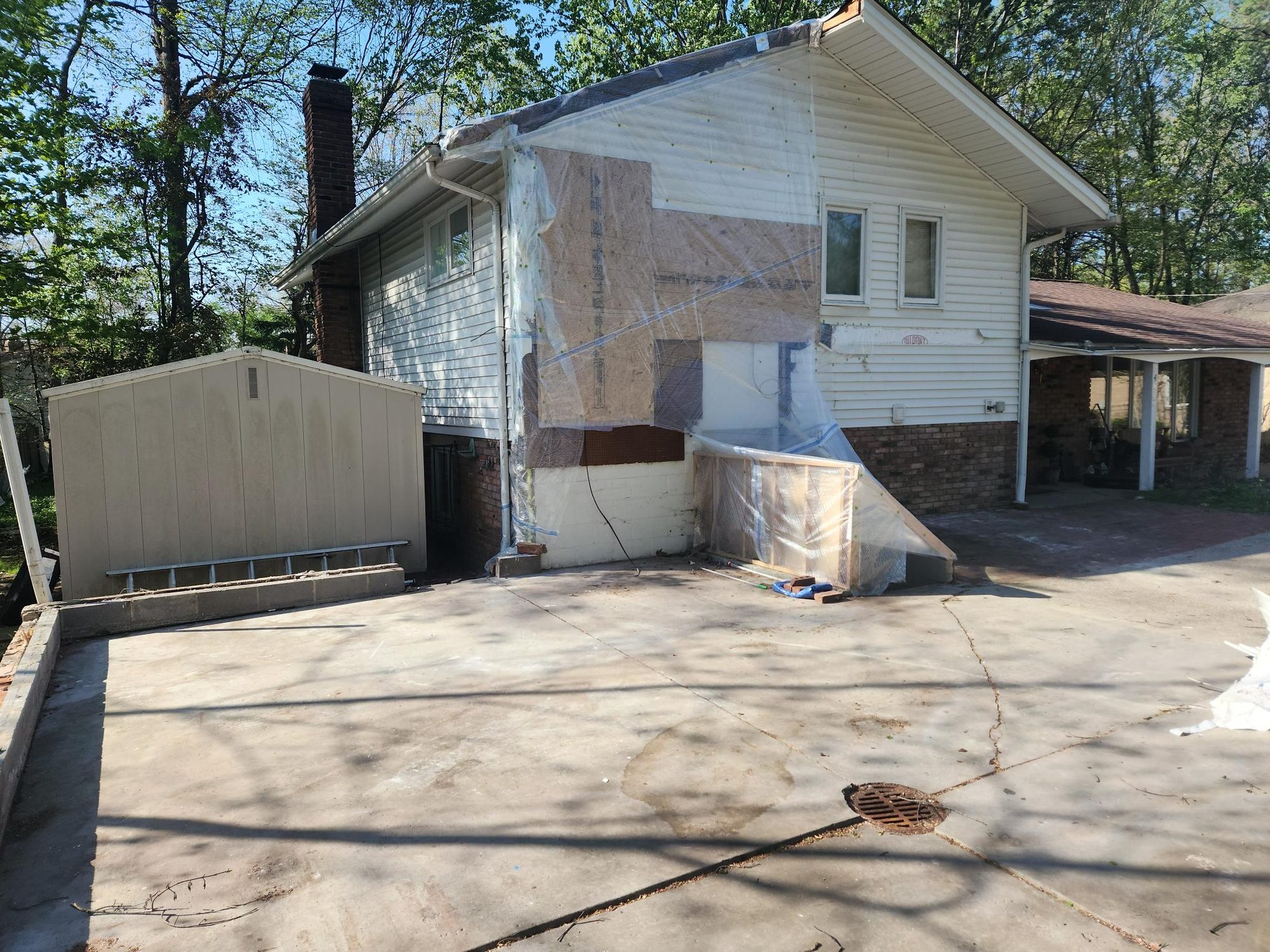

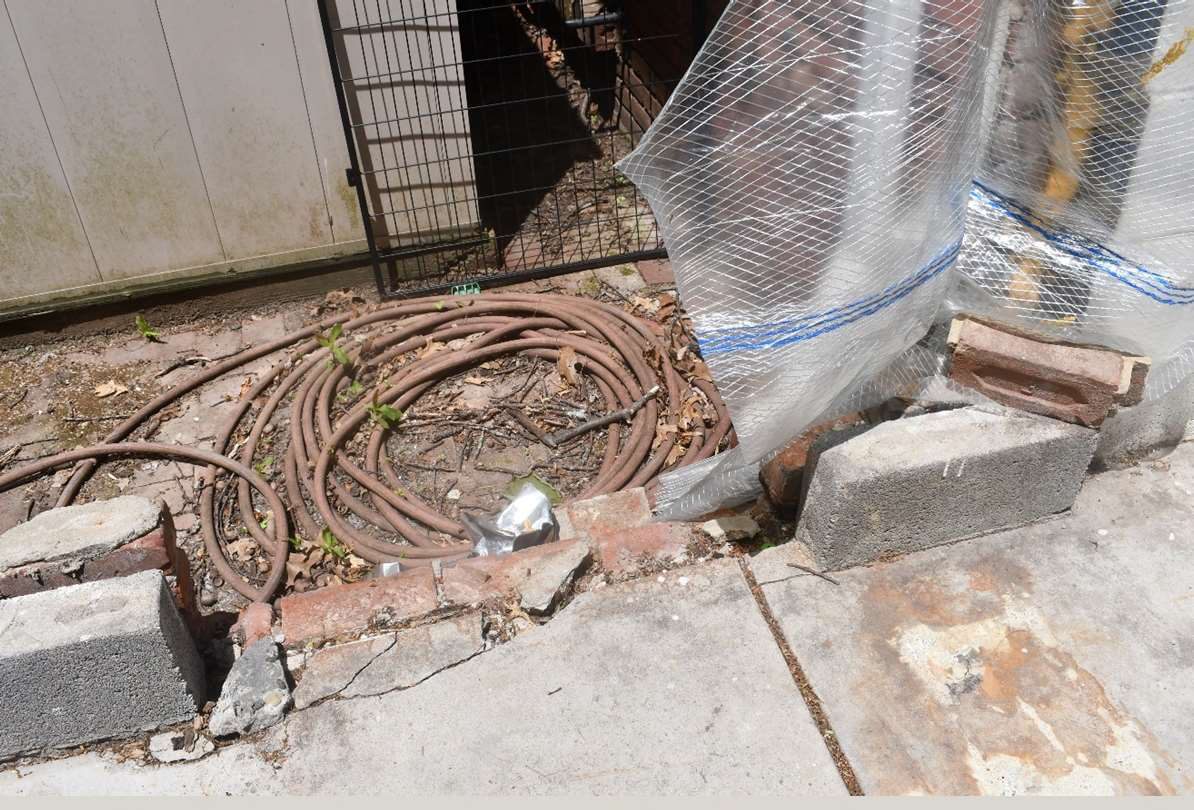

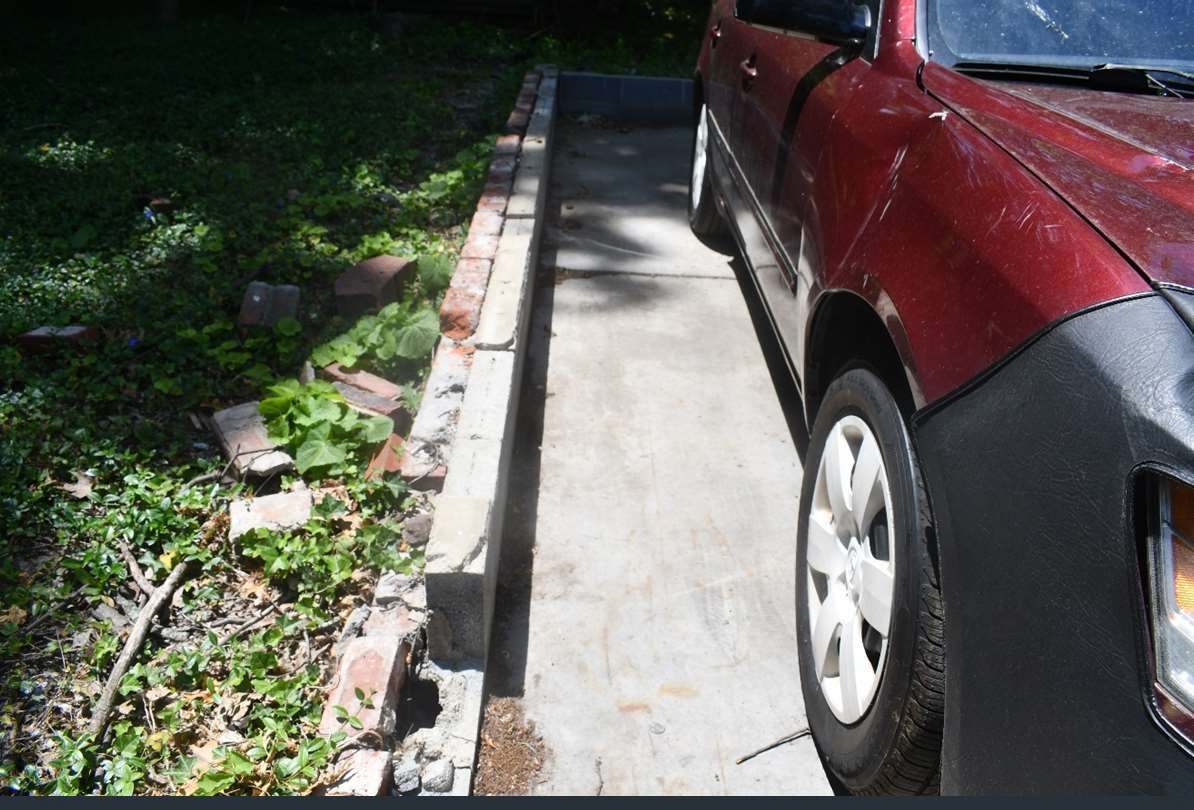

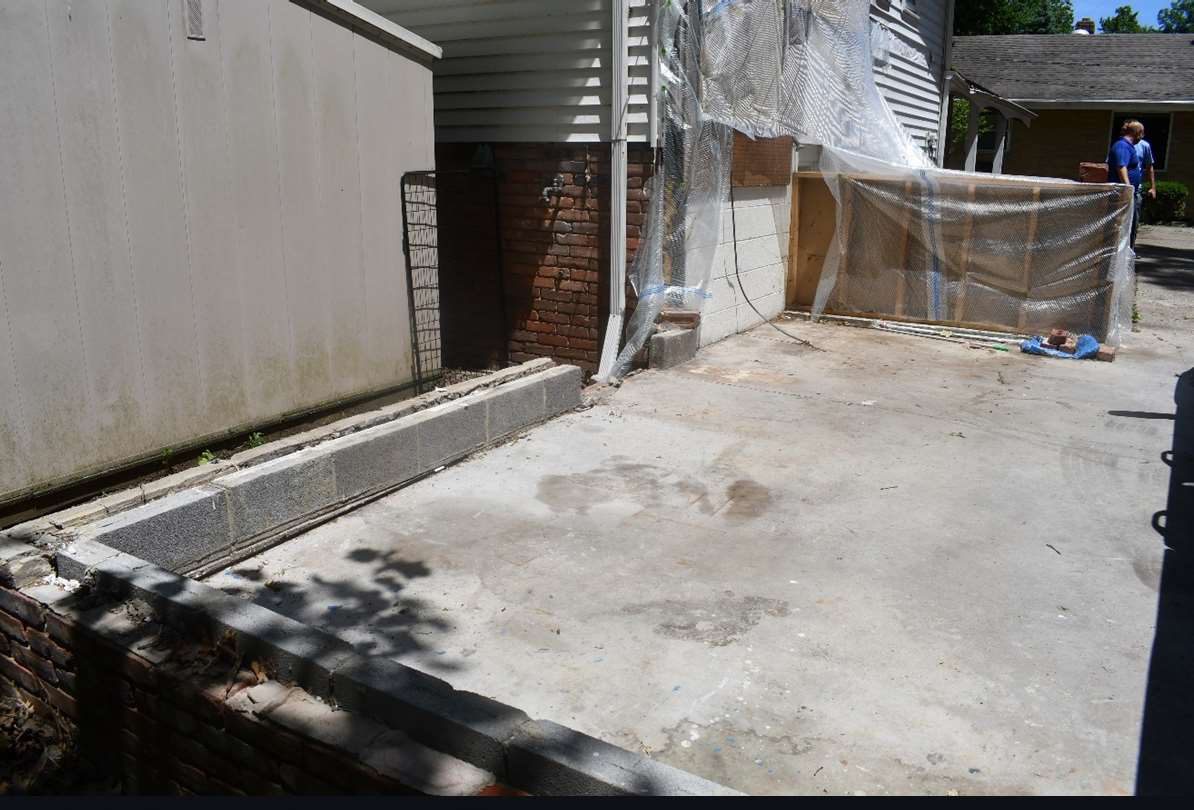

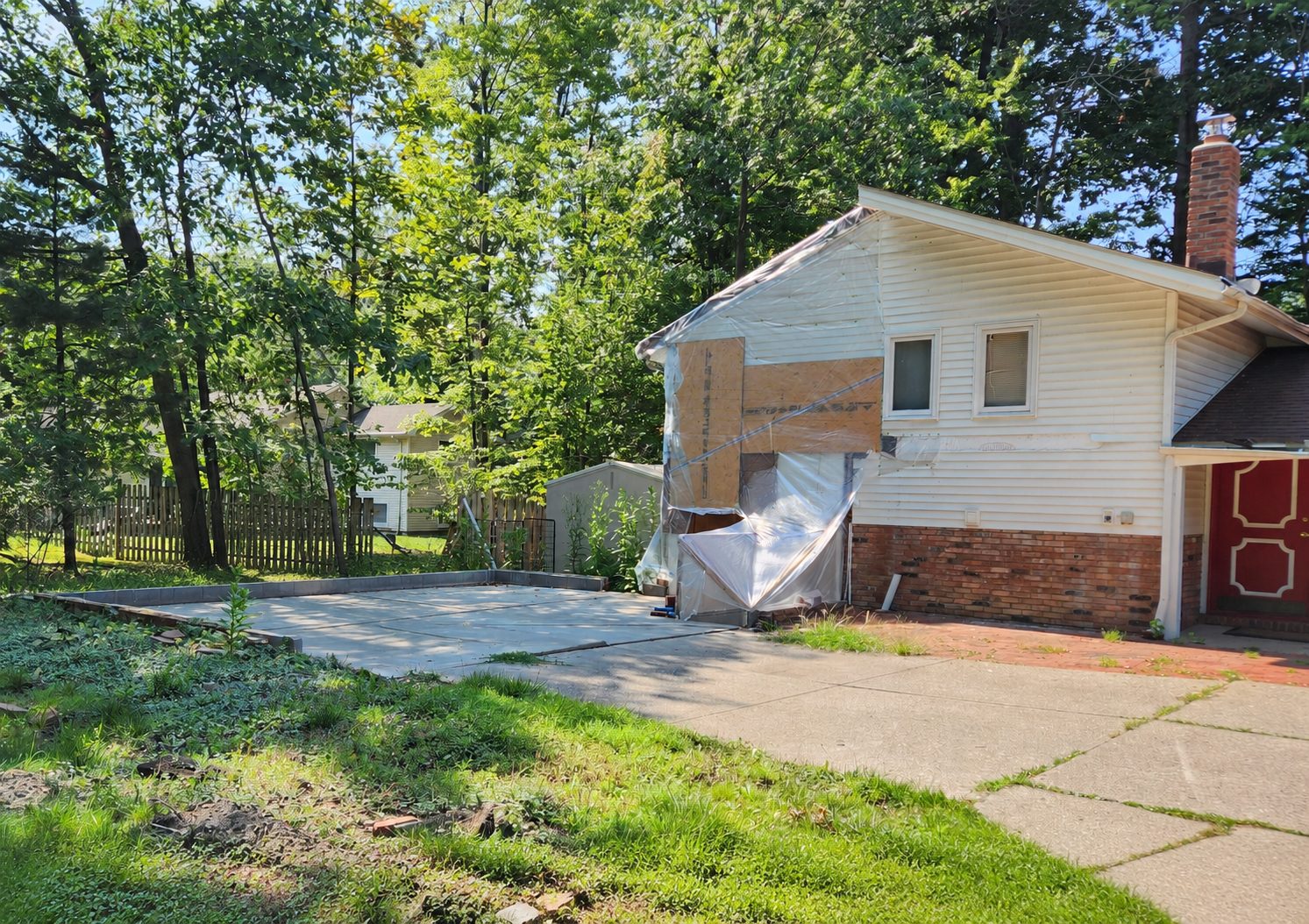

Engineer

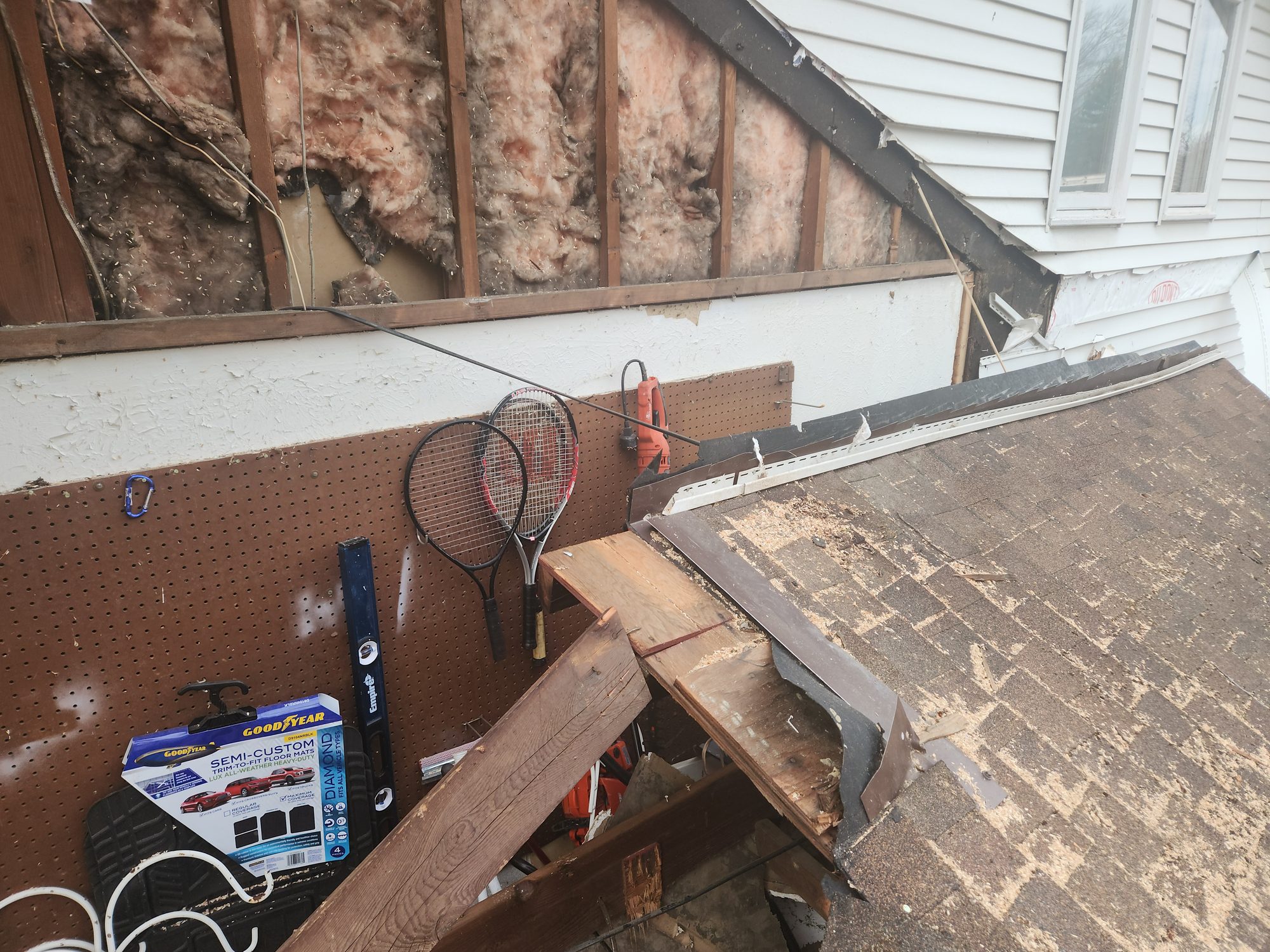

Engineer
Engineer
Engineer
Click any photo to enlarge. The first three show current conditions — the slab, the block perimeter and the exposed house wall a bidder will be working against.
The drawings
The garage is to be built to the stamped construction documents prepared by CIVITAD Services (Jud Kline, FAIA) — sheets A1–A6 plus electrical sheet E1. Bid to these drawings; they govern over any description on this page.
Bid Worksheet
This worksheet is offered as a tool, not a requirement. Use it if it helps you work up your quote — or ignore it entirely and bid in your own format. Nothing here obligates you to price line by line, to match these figures, or to submit anything on this form. The figures are shown so you know the budget before you spend time on an estimate.
| Item | Insurance (RCV) | Your bid ($) | Over / (Under) |
|---|---|---|---|
| Foundation & Slab | |||
Footings - remove and replace 4.52 CY · estimate line 84 |
$4,701 | ||
Concrete slab on grade - remove and replace, finished 6.74 CY · estimate line 87 |
$7,550 | ||
Reinforcing steel - rebar and j-bar #4 bar, 1,384 LF + 86 j-bar · estimate lines 85, 86, 88 |
$4,180 | ||
Debris haul - dump truck 2 loads · estimate line 89 |
$864 | ||
| Foundation & Slab subtotal | $17,294 | — | |
| Wall & Ceiling Framing | |||
Labour to frame load-bearing walls, 16" on centre 703 SF · estimate line 78 |
$1,512 | ||
Wall framing lumber - 2x4 material · estimate lines 75, 76, 77, 80 |
$603 | ||
Headers and beams - 2x10 material · estimate lines 79, 81 |
$154 | ||
Wall sheathing - 1/2" CDX plywood 675 SF · estimate line 82 |
$1,555 | ||
Ceiling joists - 2x8 570 SF · estimate line 83 |
$2,197 | ||
| Wall & Ceiling Framing subtotal | $6,021 | — | |
| Roof Framing | |||
Rafter lumber - 2x6, 2x8, 2x10 material · estimate lines 14, 15, 16, 17, 18, 19, 20, 21 |
$755 | ||
Rafter labour, including slope allowance 5/12 to 9/12 · estimate lines 22, 23, 24, 25, 26 |
$2,262 | ||
Garage roof sheathing - 1/2" CDX plywood estimate line 27 Depreciation on this line is non-recoverable. |
$1,179 | ||
Gable end wall - framing, studs and sheathing estimate lines 28, 29, 30, 31, 32, 33, 34, 35, 36 |
$732 | ||
| Roof Framing subtotal | $4,927 | — | |
| Interior Finish | |||
Drywall - hung, taped, ready for texture 1,259 SF · estimate lines 90, 93 |
$4,590 | ||
Texture, seal/prime and two-coat paint 1,259 SF · estimate lines 91, 92, 94, 95 |
$4,579 | ||
Cabinetry - full-height utility units 25 LF · estimate line 98 |
$4,749 | ||
Baseboard, pegboard and trim paint estimate lines 96, 97, 99 |
$486 | ||
Interior light fixtures and bulbs 4 fixtures · estimate lines 100, 101 |
$315 | ||
| Interior Finish subtotal | $14,719 | — | |
| Doors & Windows | |||
Overhead garage door, hardware, weather stop and opener 16' x 7' · estimate lines 102, 103, 104 |
$2,906 | ||
Windows, trim set and paint 4 fixed windows · estimate lines 105, 106, 107, 108 |
$3,114 | ||
Man door - insulated metal, lockset and deadbolt, painted 1 · estimate lines 109, 110, 111, 112 |
$1,091 | ||
| Doors & Windows subtotal | $7,111 | — | |
| Electrical | |||
110 volt wiring runs, boxes, outlets and switches 16 runs · estimate lines 11, 12, 13 |
$1,418 | ||
| Electrical subtotal | $1,418 | — | |
| General Conditions | |||
Dumpsters - approx. 40 yards 2 loads · estimate lines 4, 5 |
$2,282 | ||
Temporary toilet 4 months · estimate line 6 |
$864 | ||
Final construction cleaning 570 SF · estimate line 10 |
$259 | ||
General labour and misc. material estimate lines 8, 9 |
$54 | ||
Taxes, insurance, permits and fees bid item - see note below · estimate line 7 |
$0 | ||
| General Conditions subtotal | $3,459 | — | |
| Funded scope — total | $54,950 | — | — |
Two notes on this worksheet.
Permits are carried at $0.00. Progressive entered “taxes, insurance, permits and fees” as a bid item with no money against it. Price permits on that line anyway — the owner will submit it to the adjuster as a supplement.
The garage exterior is funded on the House page, not here. Siding, house wrap, soffit, fascia, gutters, the brick knee wall, the aluminium window wraps and the exterior lights sit in the estimate’s Front Elevation group, which covers the house wall and the garage exterior together. If your bid includes any of that work, price it on the House worksheet so it isn’t counted twice. Roof shingles are the same story — they are funded on the Roof worksheet.
Already completed — funded, and not part of any bid
| Item | Insurance (RCV) | Note |
|---|---|---|
| Garage demolition | $4,257 | Belfor Property Restoration — finish demolition of the collapsed garage, tarping of the exposed two-story wall, 40-yard dumpster. Estimate line 3. |
| Emergency services — debris removal | $2,000 | A Plus Builders, invoice #1542. Partial removal and haul-away of collapsed garage debris. Estimate line 2. |
| Chimney — rebuild, flashing, cap and flue | $8,579 | Masonry chimney and flue, chimney flashing, concrete cap, flue cap, furnace vent, scaffolding. Estimate lines 48–55. |
| Tree removal | $0 | Carried at zero on the estimate — the removal bid was still under review when it was written. Estimate line 1. |
- Garage-related scope only — everything else on the insurance estimate (house roof, chimney, etc.) is excluded.
- Lines marked “(garage)” are the garage share of insurance lines that combine garage and house work; verify against site conditions and the architect’s drawings.
- Roof shingles are funded from the roof allowance rather than the garage allocation — coordinate so the work isn’t double-counted.
- Prepared by the owner from the Progressive / American Strategic Insurance adjuster’s estimate. Figures are the funded target, not a directive on how to price your work.
